Assigning Work

In addition to creating pararuns, you may also be concerned with assembling a weekly roster that drivers can pick.

About this task

Work assignments are built in the Build Weeks step. The Assign Work button on the navigation bar on the left opens the Assign Work step, which shows all assignments that have been made.

Procedure

  1. Click the Assign Work step button:
    Button with the words Assign Work.
    The Assign Work step appears.

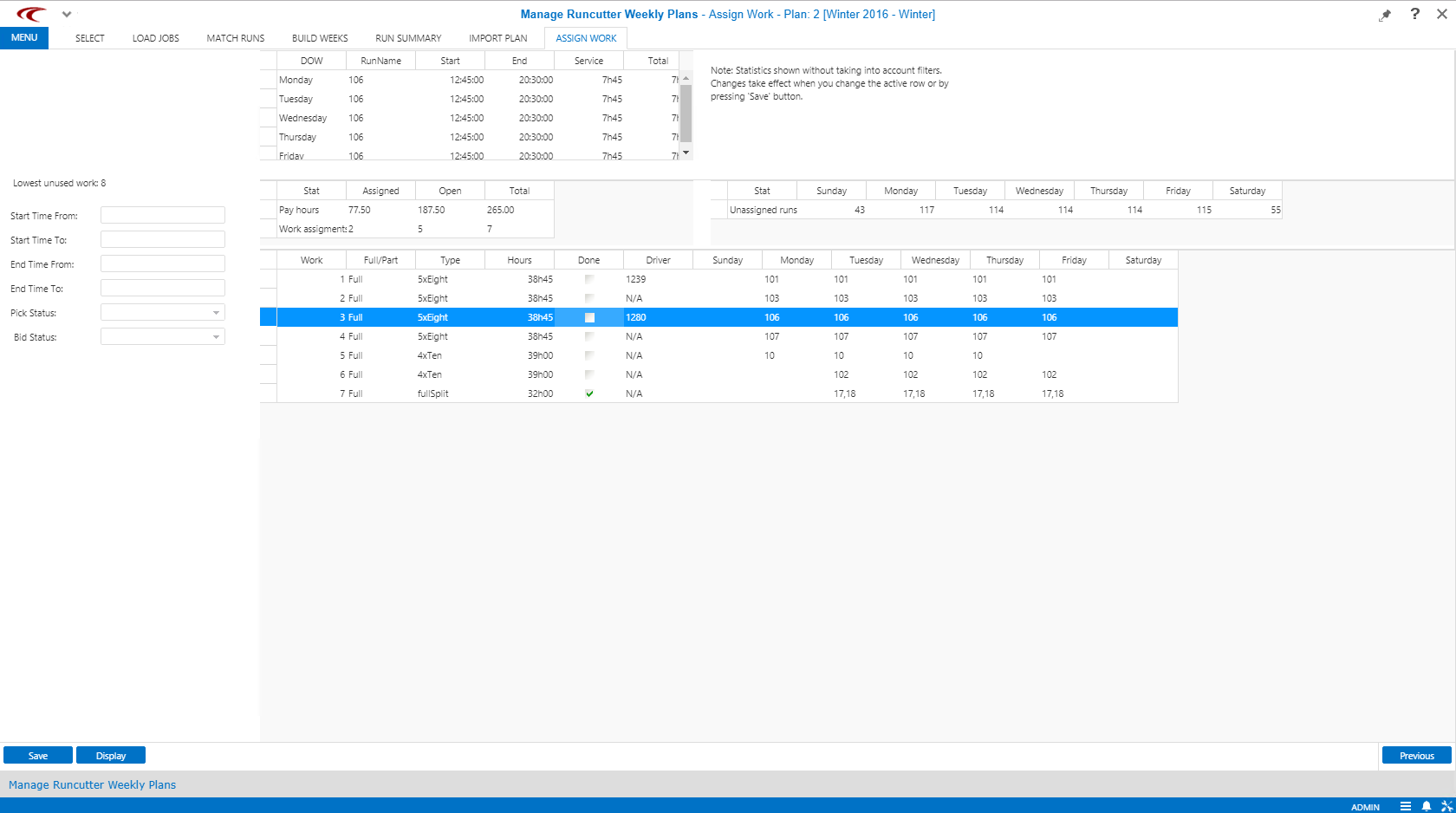

    Manage Runcutter Weekly Plans open to the Assign Work step.
  2. Fill in or select the appropriate option in the filter fields:
    Pullout Time From
    Earliest start time.
    Pullout Time To
    Latest start time.
    Pullin Time To
    Earliest end time.
    Pullin Time From
    Latest end time.
    Pick Status
    Status of work whether assigned or not: All, Done, Not Done.

    The default is All.

    You can change the status of individual rosters in the results pane. For example, if you click Not Done and you select the Done check box of a record in the grid later, that record disappears when the view is refreshed. This allows you to see only your unfinished work.

    Bid Status
    Status of work whether run has been assigned to a driver: All, Unassigned, Assigned.

    The default is Unassigned.

    If Assigned is selected, only work assigned to a driver is shown. If Unassigned is selected, only work with no driver is shown.

  3. Click Display.
  4. Click Save.

Results

Any runs that have been assigned a work ID are assembled to show these runs as a single row in the grid that represents the weekly assignment. Note that if two runs are assigned to the same driver on the same day, for example, a split, they are both shown.
  • The only editable columns on the primary grid are: Full/Part, Type, Done, and Driver.

    To make bulk edits (for Full/Part, Type and Done), press CTRL while selecting the work rows to be updated. Right-click on one of the work rows and click Edit Record(s).

  • The value in the Full/Part column defaults to F.

    You can type F for full-time or P for part-time.

  • The check boxes in the Done column are not selected by default. You can select them to indicate that the bid item is complete, which you should do when you have gotten the weekly total as close to 40 hours as possible. This is a way to flag it as not needing further attention when preparing a bid.

On the grid in the top section of the right pane, daily run details are shown for the work assignment highlighted in the main grid. (See the row highlighted in blue in the graphic.)

The value in the Service column corresponds with the Pay value in the Build Weeks step.

The Total column represents the full time elapsed from pull-out to pull-in, including lunch breaks.

The Pay amount shown in the main grid for the work assignment represents the sum of the Service hours from the detail grid.

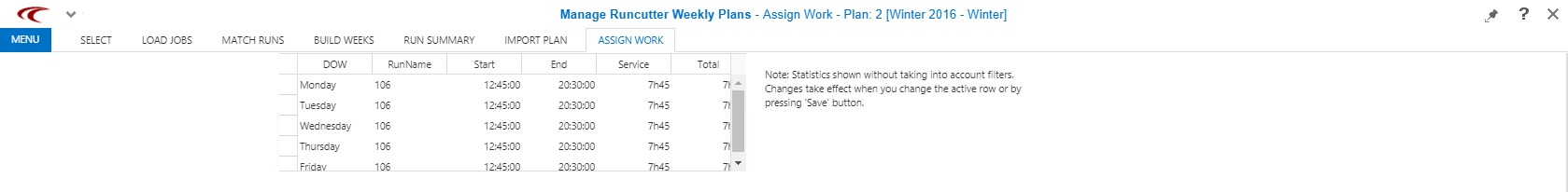

Assign Work showing a grid containing DOW, RunName, Start, End, Service, and Total columns.

On the middle section of the right pane, the two grids show the following data:

Assign Works showing a grid containing Sta, Assigned, Open, and Total columns and a grid showing Stat, Sunday, Monday, Tuesday, Wednesday, Thursday, Friday, and Saturday columns.
Pay Hours and Work Assign
In these rows, the values in the Assigned column indicate those associated with an employee and those under the Open column are those that have not been assigned to an employee.

The Total column shows the total number of hours for all runs that are part of the work assignment.

Unassigned runs
Shows the number of unassigned runs for each day of the week.
